Budget and scopeClient Guide

Luxury Home Architect Fees: Components and How to Read Them

Read a luxury home architect fee by stages, consultants, revisions, and site observation—not by a lone percentage headline. (Sep 2026)

DarcStudio
Sep 8·4 min read
Luxury Home Architect Fees: Components and How to Read Them

An architect fee for a premium home in Indonesia is almost never one clean percentage. It is a package of stages, deliverables, exclusions, and a defined cost basis, plus rules for revisions and site work. In Jakarta and similar markets (as of Sep 2026), a lower % that leaves out permits, engineers, or construction observation is not cheaper. It is incomplete.

Owners who hire for a residence or private villa usually compare proposals under pressure — family calendar, land already bought, a contractor already whispering numbers. The useful question is not “what is the standard fee?” Online “standard %” figures are marketing. The useful question is whether two proposals cover the same work on your plot.

What usually sits inside a residential fee

Firm names differ. The work does not. A full-service residential appointment often runs through some version of:

  • Concept / schematic
  • Design development
  • Permit / authority drawings (PBG package and supporting sheets)
  • Construction documents
  • Tender / contractor selection support
  • Site observation / construction administration

A proposal that only prices schematic looks calm until you need construction documents under a hard date. If a stage is optional, it should be priced as optional — not buried in a slogan like “full service.”

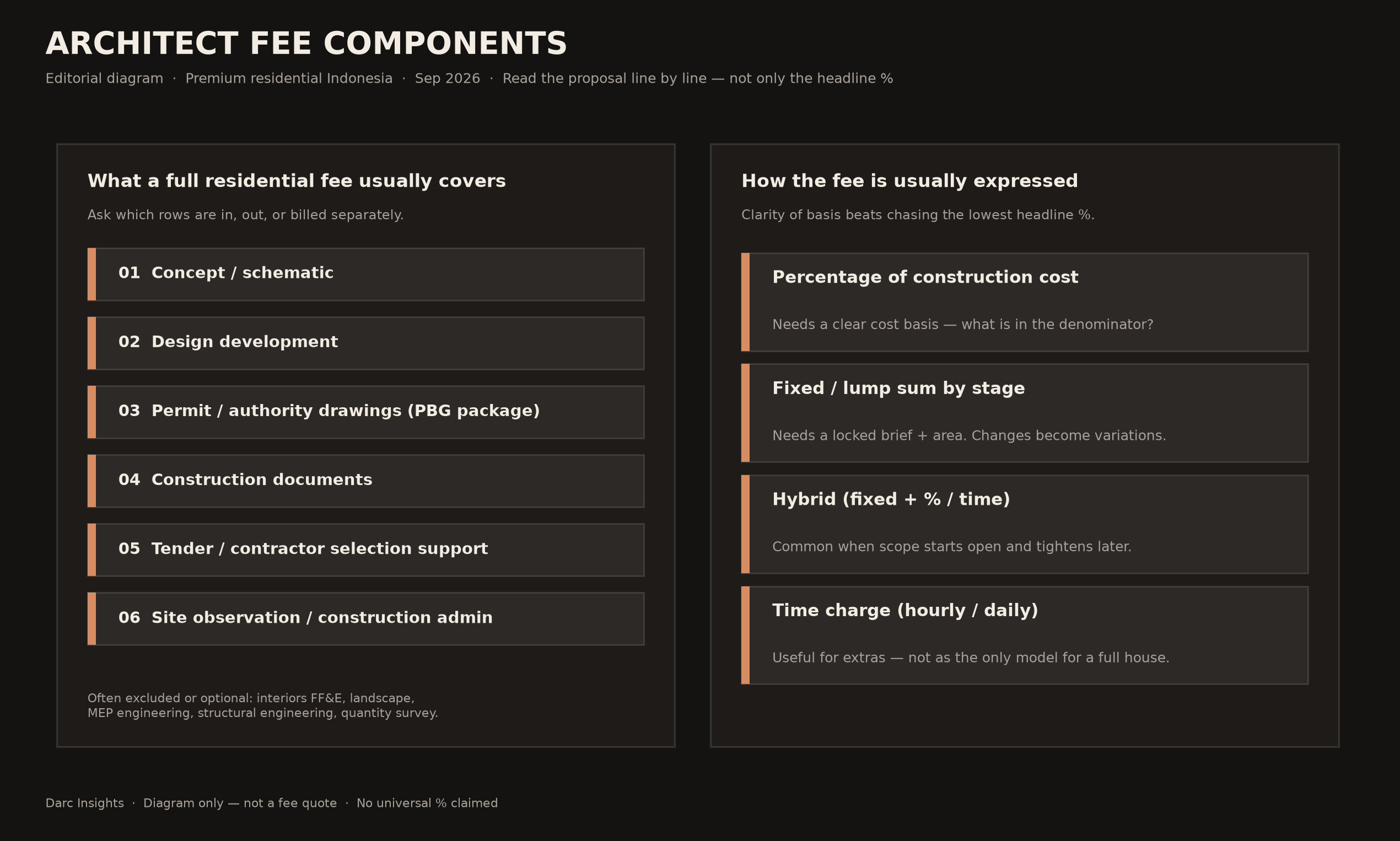

Architect fee components stack and how fees are expressed

How fee components and fee expressions usually stack

What often sits outside the architect line

Owners often assume engineers and interiors ride inside the architect fee. In our experience they often do not, unless the appointment says so in a line item.

Common separate contracts or owner costs: structural and MEP engineering, quantity survey, interiors and FF&E, landscape, specialist lighting or AV, and government authority charges (distinct from the drawing package that supports PBG).

Leaving structure and MEP as “to follow” without a budget placeholder is how coordination gaps show up at tender.

Percentage, lump sum, or hybrid

How the number is written matters as much as the number.

Percentage of construction cost needs a clear denominator: structure only, or fit-out, landscape, tax, owner-supplied items? Without that definition, every upgrade becomes an argument.

Fixed or lump sum by stage needs a locked brief and area. Changes become variations — which is fine if the variation rule is written.

Hybrid appears often when the brief is still open: time or a small fixed fee for early exploration, then a clearer basis once the program settles.

Time charge suits extras and studies. It is a weak sole model for a whole house unless stages and a ceiling are tight.

A clear, auditable basis beats a flattering headline percentage.

Revisions and site presence

Unlimited revisions in marketing copy often become billable change once the schedule slips. Ask how many design rounds sit inside each stage, and what counts as a new instruction.

Site observation without a visit cadence is a promise without a plan. Monthly presence and weekly presence are different products. Match the fee to the envelope and detailing you actually want protected on site.

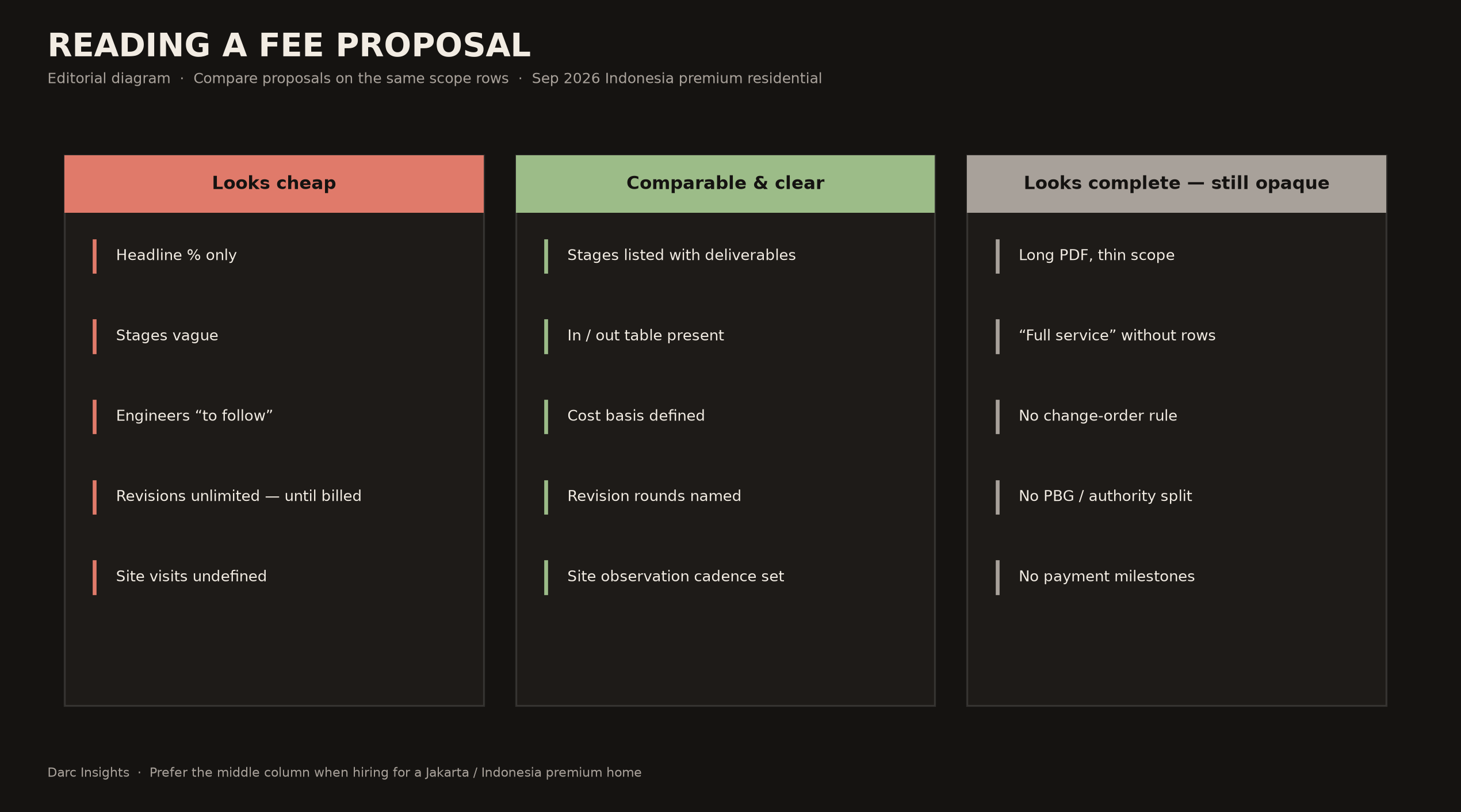

Diagram: how to read an architect fee proposal — cheap vs clear vs opaque

Reading a fee proposal for clarity versus opacity

How fee disputes usually start

On premium residential work, disputes almost never begin with the percentage alone. They begin when schematic was priced as if it were construction documents, when PBG drawings were assumed included, or when site visits were left undefined while the owner expected weekly presence.

Projects such as L House, The Balai, and Cipayung House each needed early agreement on which stages, consultants, and observation level matched the build. That is procedural, not a universal fee formula. Lock the fee table to the same scope the drawings will carry.

Fee level usually moves with site and neighbour complexity, documentation depth for permits and tender, coordination across engineers and interiors, observation intensity, how many options you explore before the stage locks, and whether the practice is STRA / IAI-backed work versus unlicensed draughting. Those are not interchangeable.

Ask shortlisted firms for ranges only with date, city, approximate floor area, stage list, and what is in or out.

Proposal comparison checklist

Use this when you lay two proposals side by side—not as a ritual, as a comparison sheet:

  • Stages listed with deliverables (not slogans)
  • In / out table for engineers, interiors, landscape, QS
  • Cost basis defined if the fee is percentage-based
  • Revision rounds and meeting cadence named
  • Site observation frequency and duration set
  • Payment milestones tied to stage completion
  • Change-order / variation rule written
  • Authority fee vs authority drawing package distinguished
  • Practice licensing stated (STRA / IAI as applicable)

Questions that can wait until design

You do not need final finishes, exact furniture schedules, or a frozen landscape concept to sign a readable fee. Those belong in design development once the massing and program settle.

What you do need early: plot facts, a program that can be tested, a stage list you understand, and honesty about who hires the engineers. The rest can stay unresolved without turning the fee into fiction. If you want a second reading of a proposal against that checklist, send the stage list and site facts.

Compare proposals on the same sheet

Use the stage, consultant, revision, and site-observation checklist above. If you want a second reading of a proposal against your brief, send the stage list and plot facts.
